Change management in HRM for HRBPs and People Ops to align headcount, compensation, and approvals without execution delays.
.jpg)
Change management in HRM is the process of planning and executing workforce changes such as restructures, compensation updates, and organizational realignments.
In practice, the breakdown rarely happens at the communication stage. It happens when headcount plans, compensation decisions, and approvals no longer move in sync. The change is announced, but execution lags behind it.
Even today, nearly 70 percent of transformation efforts fail to achieve their intended outcomes. This is where change management in HRM actually makes a difference. It helps HR Business Partners and People Ops teams ensure that workforce decisions are aligned, approved, and executable under real constraints.
This guide breaks down how to align headcount, compensation, and approvals so your change holds up beyond the announcement.
It is the structured process of preparing, supporting, and guiding an organization through planned workforce transitions. It sits at the intersection of the people side and the operational side, and as the HR professional responsible for execution, you have to run both at once.
The scope is broader than most communication plans account for:
What separates HR-led change management from generic project management is that you have to align communication, headcount data, and compensation decisions simultaneously, under a timeline that almost never moves.
.png)
Not all change is the same. The level of planning required and the frameworks you reach for depend entirely on the type of change in front of you.
Structural and compensatory changes are where you are most likely to lose control of the process. These are the changes where data integrity, approval workflows, and Finance alignment matter most, and where spreadsheets and email threads break down the fastest.
Most change management writing focuses on resistance handling and communication strategy. Those matters. But in practice, change fails at the operational layer, not the people layer.
That gap shows up clearly in outcomes. Only 32% of leaders report successfully driving change adoption, which means most change initiatives either fail or underdeliver.
Here are the three breakdown points you are most likely to hit.
When a restructure is announced, headcount decisions start to move quickly. Roles get eliminated. New ones get created. Teams get realigned. Finance wants to know the cost.
If you are tracking headcount in one tool and Finance is modeling in another, the numbers are never synchronized. You approve a role elimination that appears to be a cost-saving on paper. But the fully loaded impact, including severance, open role carry costs, and backfill timelines, is sitting in a different spreadsheet that Finance has not seen.
The result: decisions get made on partial information. Budget conversations happen after the fact. And someone is always working from a version of the plan that is two updates behind.
Every restructure triggers pay decisions. Someone moves into a broader role. A team gets realigned under a different band. A retention adjustment gets approved to keep a flight-risk employee.
Without a structured compensation framework in place before those decisions are made, each one defaults to managerial judgment. One manager gives a 15% increase. Another gives 8% for the same scope change. Neither has a pay band reference. Neither has a documented rationale.
The pay dispersion compounds. By the next comp cycle, you are trying to explain pay gaps that are 12 months old with no record of how they were created.
A headcount reduction needs sign-off from Finance, Legal, and the CHRO. A role redesign needs the hiring manager and department head. A retention package needs the CPO and CFO. These approvals are conducted via email and verbal check-ins.
The problem is not that people are slow. Nobody knows where a decision is in the chain until someone asks. A role sits as approved in a spreadsheet, but has never been formally routed. A compensation change is pending approval from one approver who is traveling. The announcement is scheduled for Thursday. It is Tuesday.
Once trust erodes during a change, rebuilding it mid-transition is extremely difficult. A merit cycle delayed by two weeks because approvals were incomplete is a credibility problem that follows you into the next initiative.

There is no shortage of frameworks. The three you will encounter most are ADKAR, Kotter's 8-Step Model, and Lewin's Change Model. Each has a real use case, but treating any of them as a complete operational system is where teams go wrong.

ADKAR stands for Awareness, Desire, Knowledge, Ability, and Reinforcement. It is a people-first framework that tracks where individual employees are in the adoption process. You use it to:
When to use it: System rollouts, new process adoptions, and any change that requires individual behavior to shift. It is not designed for planning structural or compensatory change.
Kotter's model focuses on building organizational momentum for change. The steps include creating urgency, forming a guiding coalition, building a vision, communicating it, removing obstacles, generating short-term wins, consolidating gains, and anchoring new behaviors.
It is most useful when the change is large, top-down, and requires broad organizational alignment before execution begins.
You use it to:
One important caveat: Kotter's model does not activate execution until Step 5. If your change has a hard deadline, compress this model. Do not follow it linearly if you are working against a quarterly announcement.
When to use it: Large-scale, top-down transformations where alignment and momentum need to be built before execution begins.
Lewin's three-phase model, Unfreeze, Change, and Refreeze, is a useful way to explain to leadership why you cannot move directly into a change without preparing the organization first.
When to use it: Early-stage change planning where you need to prepare, transition, and stabilize the organization through clear phases.
You use it to:
Unfreeze communicates why the change is necessary. Change manages the transition. Refreeze reinforces the new normal through updated processes, compensation structures, and org design.
This is not a generic checklist. It is the sequence that holds up in practice when you are the person responsible for both the people side and the operational side of a change. Each step covers what to do, what to have ready, and where most teams stall.
Before any conversation happens above your level, you need a clear picture of the change. That means building or reviewing a headcount model that shows the org under the proposed structure versus the current one, with budget impact attached.
At a minimum, you need to know:
This is the step where you are most likely to arrive underprepared. Leadership calls a planning meeting. You show up with a headcount list. Finance presents a budget model. Neither matches the other. The meeting stalls, and your credibility takes a hit before the change has even started.
Standard stakeholder mapping tells you who is affected by the change. That is not enough. You need a separate map that tells you who owns each decision type before the process starts.
For a typical structural change, your decision ownership map should cover:
If this map does not exist before the change starts, you will spend the first week of execution building it under pressure. Every day that decision ownership is unclear is a day the change is not moving.
Build the map. Share it with Finance, Legal, and relevant business leads before any approval routing begins. If a decision owner changes mid-process, update the map, not the email thread.
A communication plan tells you what messages go out and when. What you need beyond that is sequencing logic: who hears what, in what order, through which channel, and who is responsible for each delivery.
Sequencing errors are the most common source of trust breakdowns during change. If a department head hears about a restructure from a peer before you have briefed them, the narrative is already out of your control.
The sequence that holds up in practice for a structural change:
Each step in that sequence depends on the one before it. If approvals in Step 3 are still running when the manager briefing is scheduled, push the briefing. Communicating before decisions are locked is the single most common reason a change announcement has to be walked back.
Every pay decision related to the change must be approved, documented, and reflected in the budget before any communication reaches employees or managers. That includes:
If even one of these is still pending when the first announcement goes out, you are simultaneously managing a change communication and chasing an open approval. That is when errors happen. A manager is told that a role has been eliminated, but the severance figure has not been approved. The employee asks. The manager does not know. You have to walk it back in a one-on-one, the same day as the announcement.
Run a pre-communication checklist with Finance 48 hours before the first message goes out. If anything is unresolved, delay the communication, not the approval process.
Insider Tip: Build a simple approval tracker tied to the change timeline showing each comp decision, its approver, status, and budget impact. Share it with Finance in real time. When everything shows green, the announcement is cleared. This removes the ambiguity of 'I think we are ready' conversations.
Resistance to change is predictable. Where you lose control of it is when you treat every instance as an emotional problem that needs empathetic handling. Some resistance is legitimate, and the person pushing back has information or context you have not accounted for.
The most common forms of legitimate resistance during a workforce change:
The way to have these conversations well is to walk in with the data. That means knowing the budget, understanding the pay structure, and having the headcount model current enough to answer real questions on the spot.
The teams that handle resistance well are the ones that can say: here is the constraint, here is why this decision was made, and here is what can and cannot move. That is a data conversation. Both empathy and data matter, but the data have to come first.
Once the change is announced, the work shifts from communication to execution tracking. Most people measure adoption through engagement surveys run four to six weeks after the announcement. By then, the operational damage is already done.

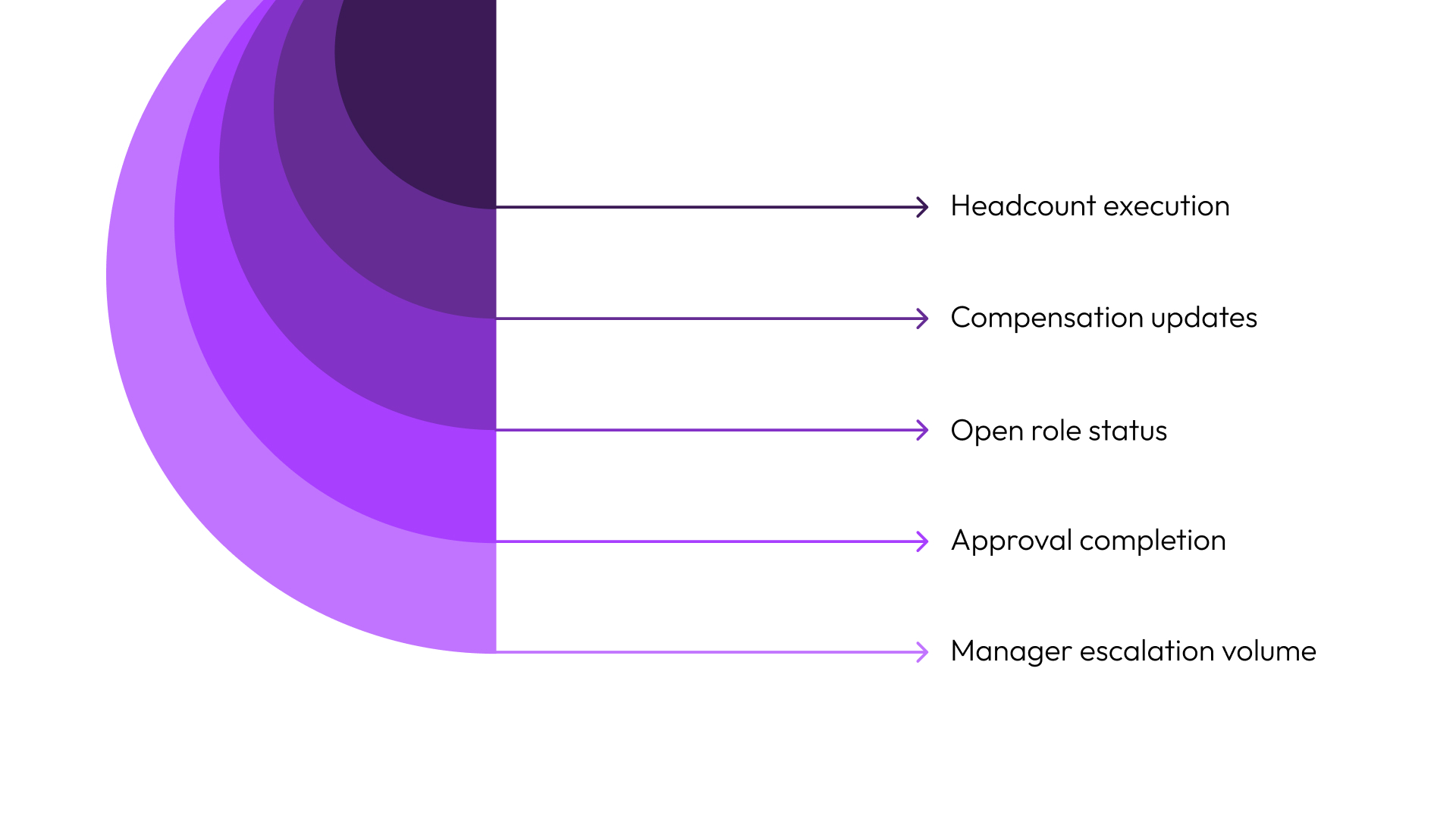

What you need to track in the first two to four weeks after the announcement is whether the change is executing as planned:
This is the step most often skipped. The change is announced, managers have the talking points, and attention moves to the next item on the roadmap. But if headcount changes are not executed and comp updates are not processed, the org is running on the old structure while the new one exists only on a slide deck.
Set a two-week check-in with Finance after every major change announcement. Reconcile actuals against the plan. If there is drift, catch it at two weeks, not at the next quarterly business review.

The fundamentals of change management do not change. What changes is the expectation of what you bring to the table before a change is announced. In 2026, three specific shifts are raising that bar.
States including California, New York, Colorado, Illinois, and Washington now require salary ranges to be posted in job postings and, in some cases, disclosed to employees on request. When a restructure creates new roles or realigns existing ones, every new or changed role needs a documented, defensible salary range immediately.
If compensation decisions during a change are made informally, they become a pay transparency problem the moment someone asks what a new role pays. You cannot manage this after the fact. The pay band needs to exist before the role is created.
According to Payscale's 2026 compensation priorities report, HR and Finance alignment is no longer optional. Compensation strategy now sits at the intersection of talent, risk, and business growth. If you present a change plan without a modeled cost impact, it is increasingly likely you will be sent back to rework before any decisions get approved.
The practical implication: you need a live headcount model that Finance can interrogate before the leadership conversation happens. Not a slide deck. A working model with toggleable scenarios.
More organizations are running AI-versus-headcount trade-off analyses before approving roles. If an AI tool can cover a function at a fraction of the cost of a full-time hire, leadership will ask the question. You need to be ready to model both options and present the comparison.
This is a new operational responsibility that did not exist two years ago. You do not need to be an AI expert. But you do need to be the person who brings the comparison to the table rather than being caught off guard when leadership asks the question.

You cannot wait for a post-change engagement survey to know whether the initiative is working. By the time those results come in, the operational damage is done. Here are the metrics that tell you whether the change is actually executing while it is still happening.
Approval cycle time and open role aging are the two most consistently overlooked metrics. Both are leading indicators. If approvals are stalling, the change is already slipping before the first employee notices. If new roles from the restructure are sitting unactioned two weeks post-announcement, leadership will start questioning whether HR can execute, and that conversation is harder to recover from than the delay itself.
For HR Business Partners and People Ops teams, change management breaks down when headcount planning, compensation decisions, and approvals are handled in separate systems. The issue is not visibility alone; it is the lack of a shared operational layer where decisions can be modeled, approved, and executed in sync.
CandorIQ addresses this by bringing workforce planning, compensation, and approval workflows into a single system, so HR and Finance are working from the same data before changes are announced.
Instead of coordinating across spreadsheets, emails, and separate systems, teams can run changes from a single workflow where headcount, compensation, and approvals move together.

Build scenario buffers into your headcount model and pre-align on cost thresholds so small scope changes can move forward without restarting approvals or reworking the entire plan.
Run a final cross-functional review in which HR and Finance validate headcount, compensation, and approvals together, ensuring every number and decision aligns before any communication is scheduled.
Equip managers with decision-backed FAQs, compensation clarity, and escalation paths so they can confidently handle conversations without routing every question back to HR during rollout.
Execution readiness determines durability, where approved decisions, updated systems, and aligned stakeholders ensure the organization operates on the new structure immediately after communication.
Centralize planning across initiatives with shared visibility into headcount, budgets, and approvals to prevent overlapping changes from creating conflicting decisions or duplicating work across teams.
